Construction Updates

The first phase of construction is nearly complete!

Work on the first phase of the streetscape is substantially complete on Main, Duane, and Hillside. The second phase of construction began in April 2023. Plans have been completed, and a construction contract has been awarded for the second and third phases of construction, to be completed over the course of the 2023 and 2024 construction seasons.

View of the completed construction on Main Street

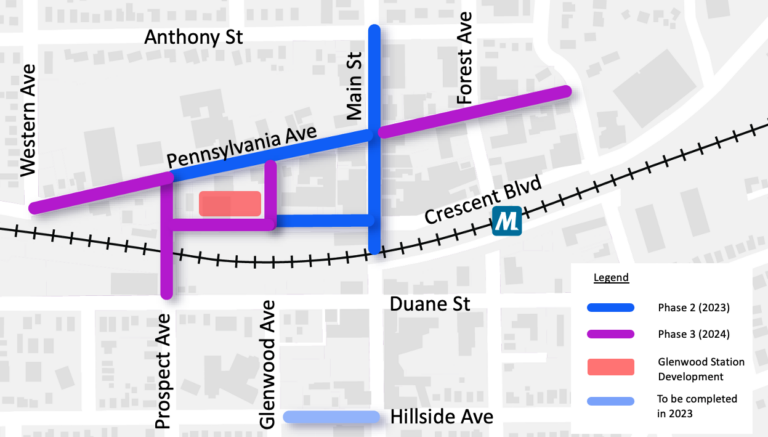

Phase 2 - 3 Construction Map

Phase 2 Construction Schedule

Downtown Parking Map

Phase 2-3 Information Meeting

Learn How Streets are Reconstructed

Contact Us

Derek Peebles

Assistant Village Engineer

Village of Glen Ellyn

 630-547-5520

dpeebles@glenellyn.org

Derek is responsible for overseeing the project and coordinating with the on-site engineer. Contact Derek with any construction and scheduling questions.
